Sydney's sewer network is over 150 years old in places. Many sites in the inner ring carry a sewer main running through them — and Sydney Water's default position is "do not build over this".

That default isn't absolute. With the right engineering, building over a sewer main is approvable, common, and on tight sites often the difference between a viable project and a written-off one.

The Sydney Water Position — Decoded

Sydney Water's concerns when something is built over a sewer main:

  1. Access — they need to be able to maintain and replace the asset
  2. Settlement — heavy structures above can settle the asset and cause failures
  3. Vibration during construction — piling and excavation can damage the bedding or pipe
  4. Long-term monitoring — if the asset fails 30 years later, who pays for the rectification

The Sydney Water "Building Over and Adjacent to Sewer Mains" document sets out the technical and procedural requirements. The pathway is structured. It is not arbitrary.

The Build-Over Engineering Pathway

The pathway has four parts. Skip any one and the application is rejected.

Asset characterisation. Before you design anything, you need to know what you're working with. CCTV survey, condition report, depth-to-invert verification, joint type, bedding material. If the existing main is in poor condition, the path may be replacement before build-over rather than protection.

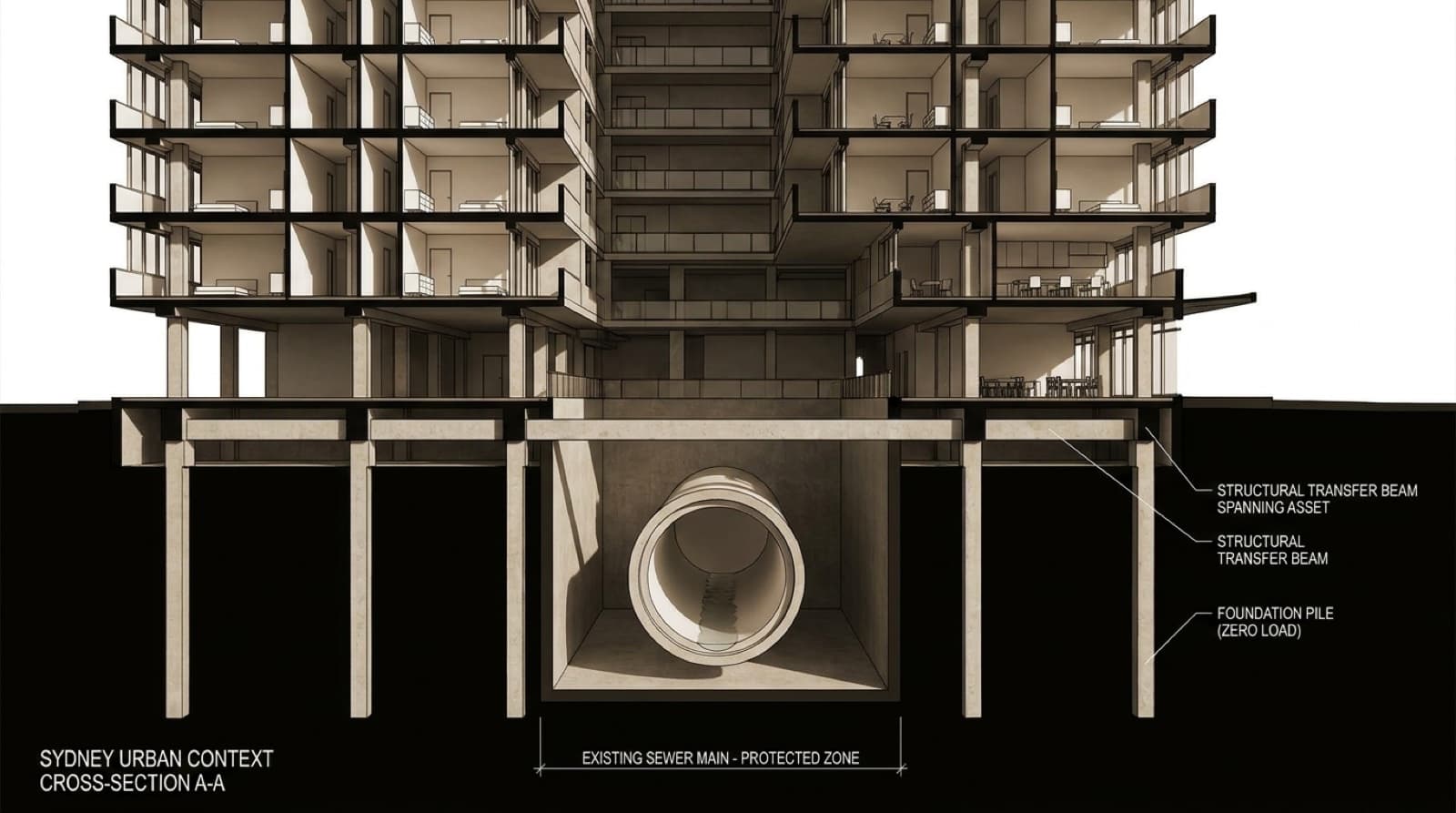

Structural design — zero load transfer. The core engineering principle is that NO point loads from the new structure may land within the protected zone (typically defined as a horizontal envelope around the pipe extending at 45° from invert). All loads are transferred to footings outside this envelope, via transfer beams, transfer slabs, or strut/tie systems.

Settlement analysis. Even with zero direct load, surcharge from adjacent foundations can settle the asset. A geotechnical settlement analysis under the proposed loading must demonstrate movement remains within Sydney Water's limits (typically 25mm total, 1:500 differential).

Construction methodology. Vibration and excavation methods within the influence zone must be specified. No piled foundations within typical limits without bored / CFA techniques. No excavation that destabilises bedding. The construction methodology becomes part of the SEA submission.

What Sydney Water Documents

The Sydney Water submission typically includes:

  • Existing asset survey and condition report
  • Architectural plans showing the proposed structure relative to the asset
  • Structural drawings showing the zero-load envelope and load transfer mechanism
  • Geotechnical report including settlement analysis
  • SEA report tying it all together with calculations
  • Construction methodology and risk management plan
  • Deed of Agreement covering ongoing rights of access

Three Practical Insights

First, Sydney Water reviews are detail-driven. A clean submission with full calculations approves faster than a polished narrative with hand-waved analysis.

Second, the deed of agreement protects all parties for the asset's remaining life. Negotiate the terms early — particularly clauses around future access and repair obligations.

Third, build-over works are insurable and bondable. Sydney Water typically requires a maintenance bond or insurance to cover potential remediation. Build this into the project budget at concept stage.

What ACSES Brings

We've designed and certified build-over works for projects ranging from boutique residential to 30-storey mixed-use. Our pattern: integrate the structural transfer into the architectural envelope at concept; engage Sydney Water with a complete package; advocate for the developer through the review cycles. We've never had a build-over rejected at first review.

George Khalil

George Khalil

Founder & Principal Engineer

almost three decades of structural, civil, and geotechnical engineering experience across 1,000+ projects.
